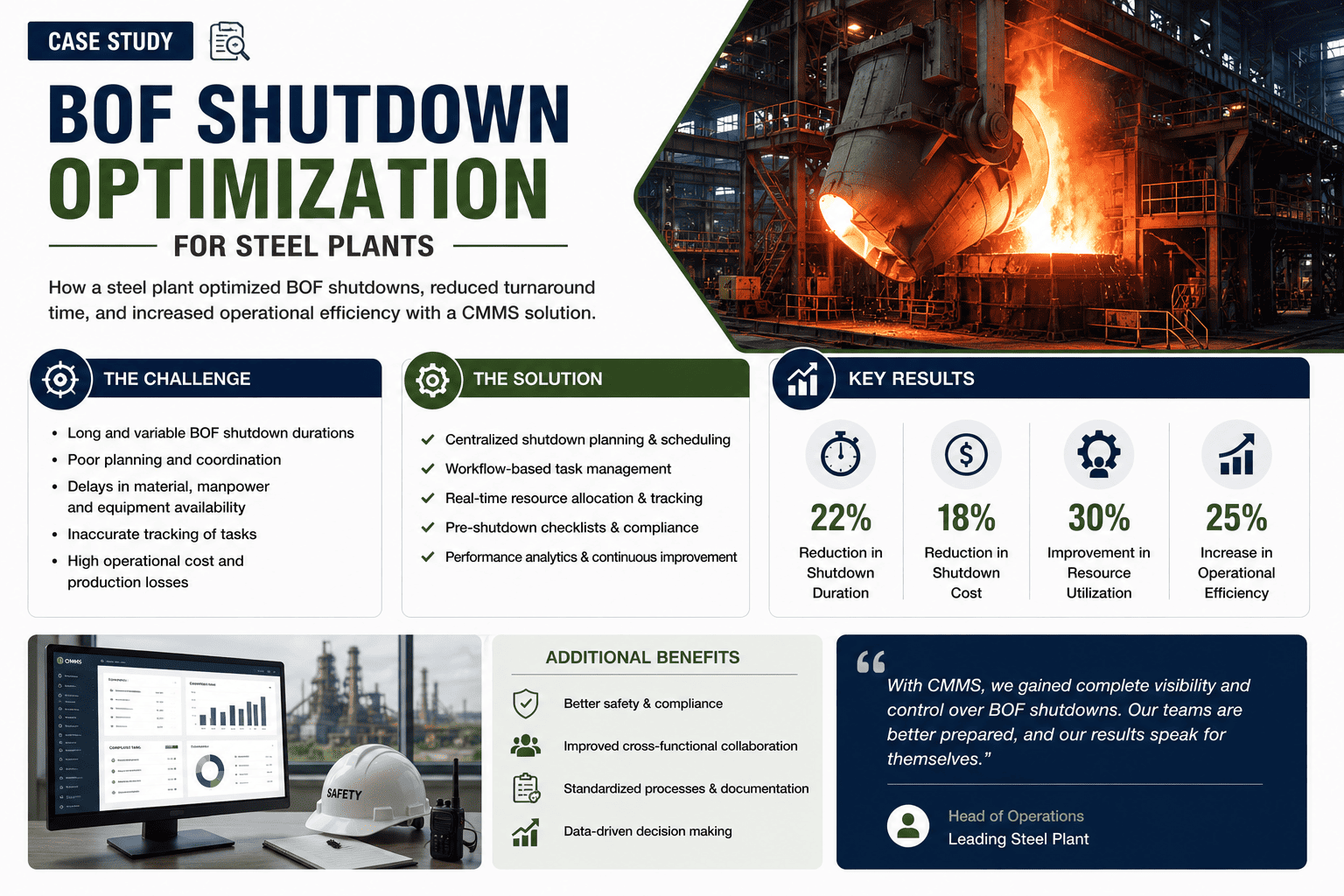

A BOF shutdown that runs a single day over schedule can cost well over a million dollars in lost production, yet most steel plants still coordinate them by radio, whiteboard, and memory. One plant's shutdowns kept slipping for the same reasons every cycle, incomplete scope, late-arriving parts, and status updates that lagged hours behind reality. Moving shutdown planning and execution into a CMMS shortened the outage without cutting corners on the work itself. Sign up to see how your next BOF shutdown could run tighter.
-30% Duration
Shorter planned shutdown length compared to whiteboard coordination
$3.6M Recovered
Production value recovered from a two-day reduction in shutdown duration
95%+ Adherence
Schedule adherence achieved by the third templated shutdown
The Problem
BOF shutdowns were planned from memory and a spreadsheet, coordinated on the day by radio and a whiteboard in the shutdown office. Status updates lagged the real state of work by hours, so slipping tasks on the critical path were often discovered only after they had already delayed the restart.
Root Causes Of Overruns
1
Incomplete Scope At Freeze
Work lists built from memory rather than a systematic condition assessment, with 20-35% of real scope discovered mid-shutdown
2
Late Material Arrivals
Parts ordered too late or with the wrong specification, stalling work packages that were otherwise ready to start
3
Slow Status Visibility
Radio and whiteboard tracking left the shutdown commander hours behind the real state of every work front
Plan Your Next BOF Shutdown Without The Whiteboard
Oxmaint connects scope, materials, contractor coordination, and critical path tracking into one shutdown workflow. Sign up for a free trial to see it against your own shutdown plan, or book a demo to walk through your next turnaround.
Shutdown Coordination Before And After
| Metric |
Before |
After |
| Scope definition |
Built from memory, revised mid-shutdown |
Built from asset condition data before scope freeze |
| Material readiness |
Ordered late, shortfalls found during execution |
Tracked against the timeline with early shortfall alerts |
| Task status visibility |
Hours behind, updated by radio and whiteboard |
Near real-time, logged from the field on mobile |
| Shutdown duration |
Frequently ran over the planned window |
Down 30%, tracking closer to the planned schedule |
The Results
None of the gains came from cutting scope or rushing the work, they came from removing the coordination lag that let small delays compound into a longer outage. Each completed shutdown is now stored as a template, so the next planning cycle starts from real execution data instead of a blank spreadsheet.
Frequently Asked Questions
Q
Why do BOF shutdowns run over schedule so often?
Overruns usually come from a chain of small planning gaps, incomplete scope, late materials, and slow status updates, that compound through the critical path rather than one single failure.
Q
How does a CMMS reduce BOF shutdown duration?
It centralizes scope, materials, contractor assignments, and critical path tracking, so slippage is visible hours earlier and status doesn't depend on radio calls or a whiteboard.
Q
Does shortening a shutdown mean cutting corners on the work?
No, the time saved comes from removing coordination delays and waiting time, not from skipping inspections or maintenance tasks that were part of the scope.
Turn Your Next BOF Shutdown Into A Templated Success
Oxmaint keeps scope, materials, contractor coordination, and critical path status in one connected shutdown workflow. Sign up for a free trial to see it against your own shutdown plan, or book a demo to walk through your next turnaround.
